Bribie Island emergency works

What we're doing about the Bribie breakthroughs to help protect Golden Beach and Pumicestone Passage.

Dredging works complete and focus now on stabilisation and investigation of long term options

Emergency works on Bribie Island to close Breakthroughs #2 and #3, create a sand erosion barrier and open an internal channel to reconnect Bulcock Beach with Pumicestone Passage, were completed on 19 March 2026.

The emergency works have enhanced protection of Golden Beach and Pumicestone Passage and improved the water quality and navigability of the passage, allowing the Caloundra Coast Guard to return to their headquarters at Bulcock Beach.

Stabilisation of the erosion barrier with sand fencing in place and a vegetation trial underway.

The Coordinator-General has commenced planning and investigations into the long-term options to ensure the resilience of Bribie Island and Pumicestone Passage.

What’s been done so far

Since emergency works began in late-September 2025 we’ve:

  • dredged over 1.1 million cubic metres of sand to close the island breakthroughs
  • closed and stabilised breakthroughs #2 and #3
  • opened an internal channel between the northern end of Pumicestone Passage and the tidal entrance at breakthrough #1
  • constructed an extensive sand erosion buffer that now stands approximately 5 metres high
  • installed stabilisation treatments, including sand fencing and vegetation.

These works were informed by independent expert recommendations and community feedback gathered during consultation.

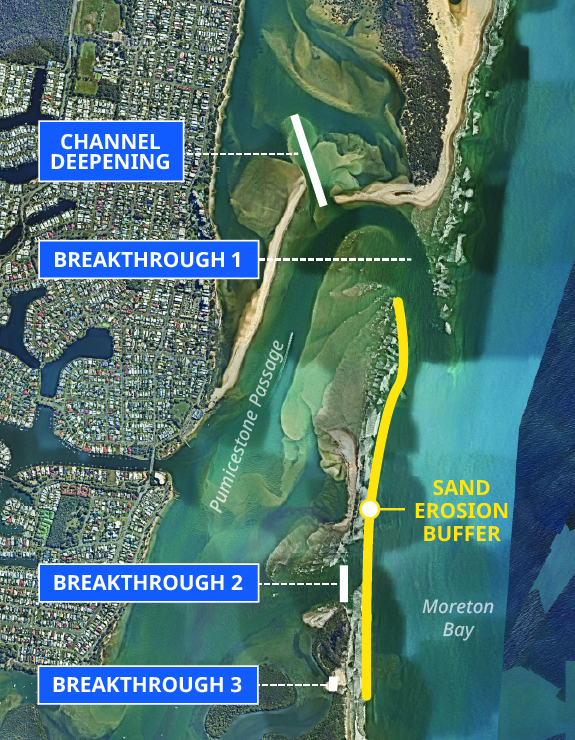

The works are marked on the map:

Location map – Emergency works site at Woorim Park, Golden Beach

Note that re-opening the Caloundra Bar at Happy Valley is not part of the emergency works scope.

Major milestones

  • Site established: 29 August 2025
  • Dredging commenced (the Arnhem): 27 September 2025
  • Breakthrough #2 successfully closed: 13 November 2025
  • Breakthrough #3 successfully closed: 28 November 2025
  • Second dredger deployed: 29 November 2025
  • Channel deepening campaign completed: 19 March 2026
  • Dredging works completed: 19 March 2026
  • Stabilisation sand fencing completed: 24 April 2026
  • Woorim Park restoration: April to June 2026
  • Vegetation trials commenced: 2 June 2026

Longer-term actions

The Queensland Government has considered the recommendations of the independent review of the Bribie Island Erosion and Breakthrough Events.

The emergency works have provided immediate protection to local communities and their coastal and marine environments. Investigations and early planning continue to progress considerations and recommendations of the Bribie Island Erosion and Breakthrough Review.

Community notifications and project updates

Looking for alternative off-leash dog parks?

Subscribe

Want to stay informed about the progress of the Bribie Island erosion and breakthrough? Subscribe now to receive updates directly to your inbox.



Frequently asked questions

The Bribie Island Emergency Works aim to address the significant environmental challenges caused by breakthroughs along Bribie Island resulting from recent cyclone activity, which has threatened coastal communities, the stability of the island and Pumicestone Passage.

The works have closed the two southern breakthroughs, buffering Bribie Island to enhance protection of Golden Beach and the Pumicestone Passage marine environment, and improving access and water flows to the northern section of the Passage.

Undertaking the emergency works has created time to plan for longer-term strategies and solutions.

The emergency works have:

  • stabilised Bribie Island to reduce risk of storm damage to private property, essential community infrastructure and areas of natural and cultural significance within the Pumicestone Passage area, including Ramsar-listed wetland
  • supported the health of Pumicestone Passage by ensuring proper tidal flow and sediment management
  • provided increased resilience to future weather events by reinstating a physical barrier at Bribie Island and reducing the risk of further environmental damage.

Vegetation planting on the reclaimed sand dunes is a fundamental part of the emergency works. A plantation trial is underway. Planting atop of newly placed sand will help to stabilise the dunes by trapping sand, reducing wind speed and binding sub-surface materials with their roots. Detailed design is underway for implementation once beach nourishment is complete.

You can read the Queensland Government’s response to the recommendations of the independent review of the Bribie Island Erosion and Breakthrough Events along with all four reports.

The government has asked the Coordinator-General to lead the investigation and implementation of the recommendations for longer-term solutions for Bribie Island. While remaining focused on completing the emergency works, the Office of the Coordinator-General has commenced planning to assess the longer-term options.

The purpose of the emergency works is to provide immediate protection for the Pumicestone Passage and Golden Beach coastline whilst long-term solutions are investigated and developed.

The design and scope for the immediate emergency works were informed by independent expert advice and include design principles to a one-in-10-year storm event.

If a significant weather event occurred without the emergency works intervention, additional erosion would further degrade the island, widening the breakthroughs. This would pose a significant risk to private property, essential community infrastructure and areas of natural and cultural significance within Pumicestone Passage, as well as ecological values throughout the Moreton Bay Marine Park region and associated Ramsar-listed wetland.

In response to the Breakthroughs, the Queensland Government commissioned an independent expert review to investigate the ongoing erosion and breakthrough events and their impacts on Bribie Island.

On 12 June 2025, RPS and ICM issued the Review’s Part 2 report to the State, which outlined the issues and recommended immediate options in response to the Breakthroughs. The Part 2 Report recommended four immediate actions:

  1. closure of Breakthroughs 2 and 3
  2. buffering of the remaining island segment between Breakthroughs 1 and 2
  3. further buffering of the island or construction of an inner sandbank inside Breakthrough 1
  4. dredging of a temporary channel, linking Breakthrough 1 to the northern passage.

The Report considered these urgent recommendations qualified as ‘emergency works’ given the situation.

In response to the findings and recommendations of the Review, on 26 June 2025, the Queensland Government announced funding for the rapid deployment of immediate and urgent works to remediate erosion impacts caused by the Breakthroughs and undertaking resilience works to reinstate features to mitigate against further degradation.

Re-opening the Caloundra Bar at Happy Valley is not included in the emergency works scope program.

To improve water circulation, water quality and navigational access for mariners at the northern end of Pumicestone Passage nearest Caloundra, channel deepening works have been undertaken near the tidal entrance at Breakthrough #1.

The Queensland Government approved a works regulation directing the Coordinator-General to undertake the Bribie Island Emergency works and enliven powers under the State Development and Public Works Organisation Act 1971.

The works regulation authorises the Coordinator-General to undertake emergency works in, on, over, through or across the foreshore of Bribie Island, Caloundra, Golden Beach or Pelican Waters, or on land laying under the waters of Moreton Bay, including the taking of various types of material from those places for use in the works. Additionally, these powers relevantly include power to enter and occupy land for the purposes of the works, for example to establish compounds for equipment laydown, stockpiling and contractor facilities.

In practice, this allows the Coordinator-General to work in the foreshore or submerged land and take sand from the Pumicestone Passage and the designated offshore areas.

The Australian Minister for the Environment and Water determined that it is in the national interest to grant an exemption for the emergency works from provisions of the Environment Protection and Biodiversity Conservation Act 1999. The reasons for the decision are available on the website of the Commonwealth Department of Climate Change, Energy, the Environment and Water.
